Software roadmaps: prioritising value, evidence and dependencies

Prioritise a software roadmap through business value, evidence, dependencies and capacity, with clear outcomes and an understandable decision history.

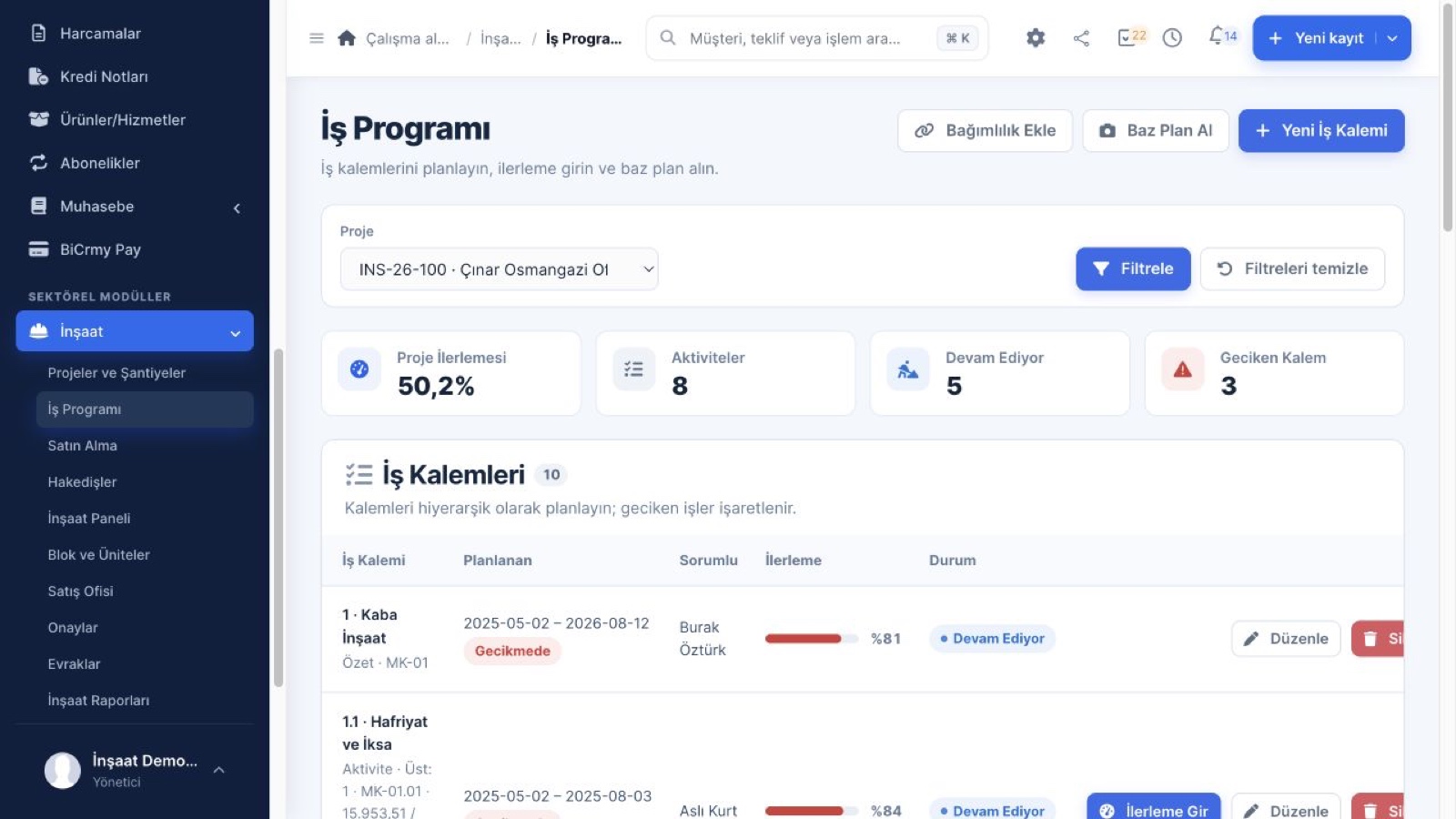

The work schedule in the BiCrmy demo application; all records are fictional

Sales wants a new quotation flow, operations wants job assignment and management wants better reporting. All three requests make sense, but the team cannot complete them simultaneously. If the meeting ends with the most forcefully defended feature going first, the software roadmap is not helping people make a decision. Prioritisation requires business value and dependencies to be discussed together.

A useful roadmap is more than a colourful chart containing every idea and a delivery date. It explains which problem the business intends to address, why it matters and what evidence supports the sequence. Work approaching delivery can carry more detail than distant possibilities. Giving an unexamined idea a precise date conceals uncertainty instead of resolving it.

Make the missing business outcome visible

“We need a new dashboard” proposes a solution. The underlying problem may be that a manager cannot spot overdue work or spends too long combining separate files. Those problems do not necessarily need the same dashboard. Reframe the request around the person who needs to make a decision and the difficulty they encounter. Alternative solutions then become available for discussion.

Record how the problem is known. Interviews, support tickets, observed tasks and operational reports provide different kinds of evidence. Replace “everyone wants it” with a description of the roles affected and the situations in which they struggle. A problem affecting one important user can still deserve attention, but that is different from evidence that the problem is widespread.

A concrete example makes the conversation more productive. Which file does the employee open, which information do they retype and where do they wait for a response? If the time involved has not been measured, do not invent a precise saving. Plan an observation and explain the uncertainty that matters to the decision. Assumptions should remain distinguishable from findings.

Discuss more than one kind of value

Revenue is not the only form of business value. Fewer errors, shorter waits, less repetitive work and more accessible information can also justify investment. Describe what would change for the business if a request were delivered. Broad claims about efficiency are less useful than an explanation of the specific behaviour or outcome expected to improve.

For a quotation problem, the relevant delay may not be the speed at which the screen opens. Users may struggle to find the approved price, wait for authorisation or repeatedly enter the same information. The benefit depends on addressing the actual bottleneck. A measurement approach that ignores it can make a released feature appear successful while the business task remains difficult.

Different teams may also mean different things by value. Operations may need reliable records while sales needs a faster response. Sometimes both goals benefit from the same change; sometimes they create a trade-off. The person making the decision should discuss that tension openly rather than assume that every feature improves every objective at the same time.

Dependencies can change a ranked list

A report may offer substantial value, but it will not deliver that value if the status information beneath it is inconsistent. Data definitions and recording behaviour may need attention first. This less visible work becomes important because it enables the desired outcome. Dependencies should be part of the business conversation, rather than information retained only by engineers.

Consider a fictional field-service application whose managers want to identify overdue jobs. One team calculates lateness from the start date while another uses the planned visit date. Before building a new chart, the business must decide what each date means. Clarifying the field, reviewing historical records and adjusting the workflow become prerequisites for useful reporting.

A dependency list should not become a justification for endless infrastructure work. Ask which outcome each prerequisite enables and how much preparation that outcome really requires. Build a sufficient foundation for the nearby goal rather than attempting to accommodate every imaginable future request. The boundary makes necessary preparation easier to distinguish from speculative investment.

Precise scores cannot strengthen weak assumptions

A simple comparison of value, reach, effort and confidence can support a discussion. Keep the reasoning alongside the score. If the expected effect is an estimate, do not present it as a measured result. Using several decimal places does not make a decision reliable and can make uncertainty less obvious to the people reviewing it.

Where candidates appear similar, discuss whether they can be divided into smaller releases, reversed if needed or used to answer an important question. A short experiment may test a consequential assumption before the business commits to a larger build. Define what will be learned and how the result changes the next decision. An experiment without a decision purpose becomes another unfinished item.

Check that estimates have comparable levels of understanding. One request may have been investigated while another exists only as a heading. Comparing their effort estimates directly can be misleading. A brief assessment of the less understood request may be worthwhile. This avoids promoting it because someone guessed a low number or postponing it indefinitely because nobody has examined it.

Separate near-term work from later possibilities

Near-term work should have clearer objectives, ownership, acceptance criteria and significant dependencies. The following horizon can explain the intended outcome and preparation required. More distant ideas may remain problems to investigate. Presenting different levels of confidence honestly makes the document easier to use and reduces the risk that every entry is interpreted as an equivalent promise.

This distinction does not remove scheduling discipline. Genuine external commitments, contractual dates and required transitions should remain visible. Explain why a date is fixed. Other work may have a target window with an explicit confidence level. Record the point at which an estimate becomes an approved delivery commitment so the change in expectations is understood.

If a near-term item remains too uncertain, look for a smaller useful release. Instead of replacing the entire reporting system, the team may complete the view needed for one recurring decision. The smaller release should allow someone to perform real work, rather than merely consist of several disconnected screens. Its use can provide evidence for the next step.

Capacity includes more than new features

Support, defect corrections, maintenance and risk reduction consume real capacity. A roadmap that pretends they do not exist becomes unrealistic as soon as an incident occurs. Avoid prescribing one universal allocation for every team. Look at the application’s condition and previous workload, then decide how unplanned work will be assessed and accommodated.

Specialist availability can also constrain sequencing. Two important items may depend on the same person and therefore be unable to progress together. Business-side activities such as agreeing data rules, reviewing designs and accepting releases use capacity too. Planning only around developer headcount hides these waiting periods and gives an incomplete picture of the delivery conditions.

When urgent work arrives, say what moves back. Adding the new priority while keeping every existing date unchanged creates fictional capacity. A short decision note can explain the new circumstances, affected work and next review point. That explanation helps people interpret a change as managed information rather than unexplained unreliability.

Follow the outcome after the release

Publishing a feature does not prove that it solved the intended problem. People may ignore the new workflow or return to the spreadsheet they used before. Agreeing an observation approach before delivery prevents the team from deciding afterwards what success should mean. Usage information and short conversations with users can reveal different parts of the story.

An unexpected result does not automatically call for more features. People may not know about the release, essential data may be missing or the solution may address the wrong bottleneck. Return to the evidence that supported the original decision. What the team learns can change the justification for its next investment. Updating the roadmap is part of using that knowledge.

Avoid turning the review into a search for someone to blame. The practical question is which assumption was incomplete and what action follows. A change that did not produce the expected benefit can still provide useful evidence if the observation is credible. Leaving the result unexplained makes it more likely that the same assumption will influence another expensive decision.

Keep a short, findable decision history

Every change does not need a long presentation. A few clear sentences can explain which problem moved forward, which evidence mattered and which work was deferred. Add the decision owner and a review point where appropriate. The next meeting can then build on the previous discussion instead of restarting it from memory.

Make the reason for deferral visible as well. A request with limited value differs from one waiting for external access. When the missing condition is satisfied, the latter can be reconsidered. Managing a roadmap alongside this decision history during custom software development keeps engineering work connected to business intent. Assign responsibility for maintaining the document so it does not become an outdated presentation.

Give each audience a way to read the plan without creating conflicting versions. Executives may need outcomes and key dependencies, while the delivery team needs the supporting work items. These views can refer to the same underlying decisions. If separate documents are necessary, establish which one is authoritative and how the others are updated when priorities change.

Frequently asked questions

Is a roadmap the same as a task backlog?

No. A detailed work list can contain implementation tasks, while the roadmap explains intended outcomes and their sequence at a broader level. The two should connect, but every technical task does not need its own line on the business roadmap. Keeping that distinction helps each document serve the people who use it.

Should the most frequently requested feature always come first?

Request frequency is useful evidence, but it is not the whole decision. Consider the scale of the effect, prerequisites, available workarounds and the effort involved. A less frequently requested foundation change may enable several valuable outcomes. Ask who is affected and how, rather than treating the number of requests as a complete measure of value.

Should roadmap dates be firm commitments?

Separate real commitments from forecasts. Work approaching delivery may be supported by more information than distant ideas. When a date is shown, explain whether it is an aspiration, an estimate or an approved commitment. The audience should not need to infer that distinction from the layout or assume that every entry has the same confidence.

How can technical debt be explained to business stakeholders?

Describe its operational effect instead of defending the technical term itself. Explain why changes have become harder, which defect repeats or which valuable work is blocked. State the proposed intervention and how its result will be checked. That gives the business a practical decision rather than a broad request to improve something that it cannot evaluate.

How often should priorities change?

There is no single frequency appropriate for every product. A regular review can be supplemented when important evidence, an external obligation or a critical incident changes the situation. Reordering work after every daily request can be as disruptive as refusing to change a plan. Keep the reason for a change visible and identify what it displaces.
